Planner Addon
Last updated 3 months ago
The Planner is a premium addon included with the Studio subscription, or as an extra with a Pro subscription.
The Planner Addon provides a comprehensive environment for production management, ranging from high-level estimates to granular task assignment. By separating production into Phases and Schedules, AYON allows studios to increase production volume while maintaining total oversight and organizational clarity.

Introduction: Planner vs. Scheduler
While they share a similar timeline interface, the Planner and Scheduler serve two distinct purposes in the production pipeline:
Phase Planner: Focused on high-level strategy, artist bookings, and production phases (e.g., Modeling, Rigging). It handles Planner Events, which are independent entities separate from specific production tasks. This allows for "soft" planning before specific assets or shots are even created.
Scheduler: Focused on the execution of specific tasks (e.g., Modeling task for
shot_010). It links directly to the production hierarchy, setting hard dates and assignees that are reflected across the studio.

Quick Start: Your First Plan and Schedule
To get started quickly, follow this high-level workflow:
Create a Track: In the Phase Planner, create a new track (e.g., "Characters").
Define a Phase: Hold Ctrl/Cmd and drag on the timeline to create a phase event like "Modeling Phase".
Switch to Scheduler: Navigate to the Scheduler tab. You will see your production folders and tasks.
Overlay the Plan: Right-click and select Show Planner to see your high-level phase ghosted over the task list.

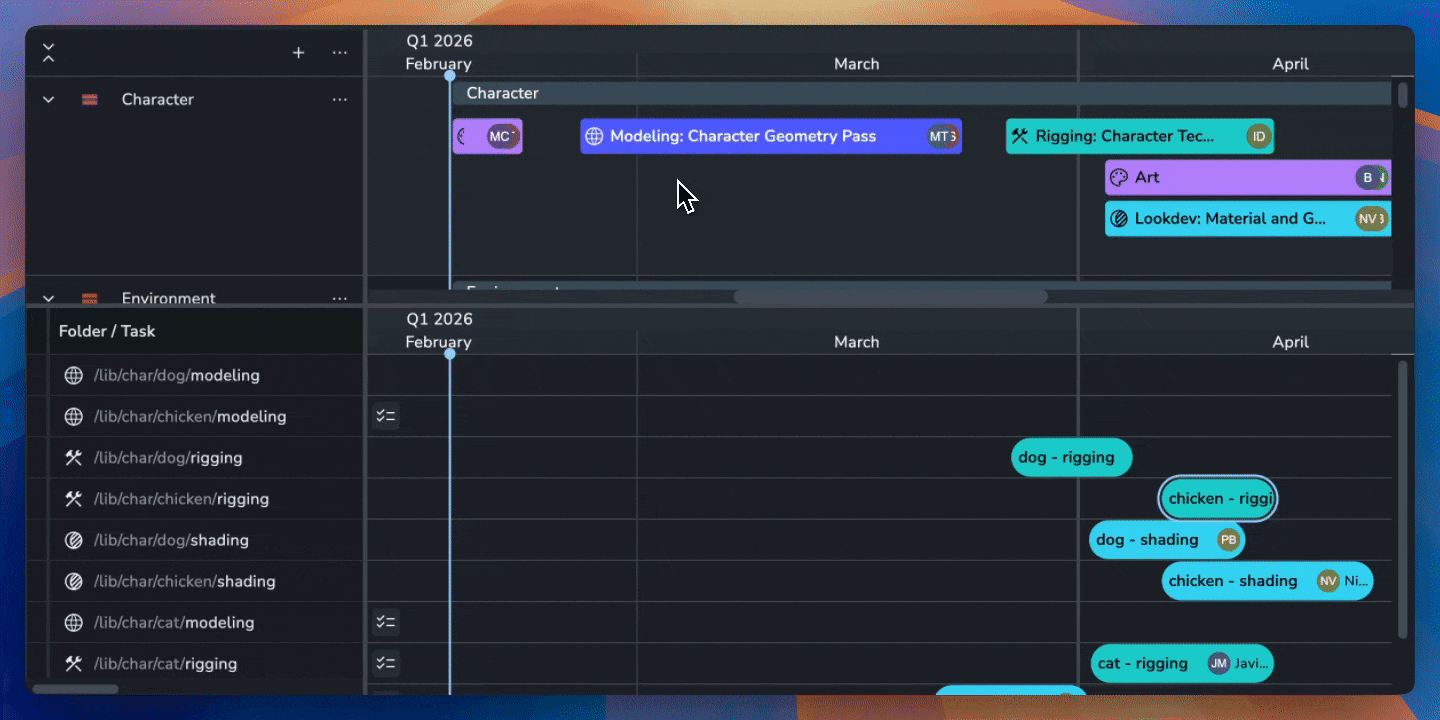

Create Schedules: Right-click your "Modeling Phase" and select Create Schedule > Task Type to automatically generate schedules for all Modeling tasks that align with your plan.
Detailed Phase Planner
The Phase Planner allows you to map out timelines without needing exact task details.
Planner Events: These can be categorized as Phase, Time Off, or Milestone.
Studio vs. Project Planning: View studio-wide events (like vacations) at
Home > Planneror project-specific details within the project’s own Planner tab.Required Data: Every event requires an Event Type, Title, and a minimum duration of 1 day.

Planner Tracks
Tracks organize events into structured "lanes," similar to tracks in video editing software.
Flexibility: Tracks can represent episodes, departments, or individual artist bookings.

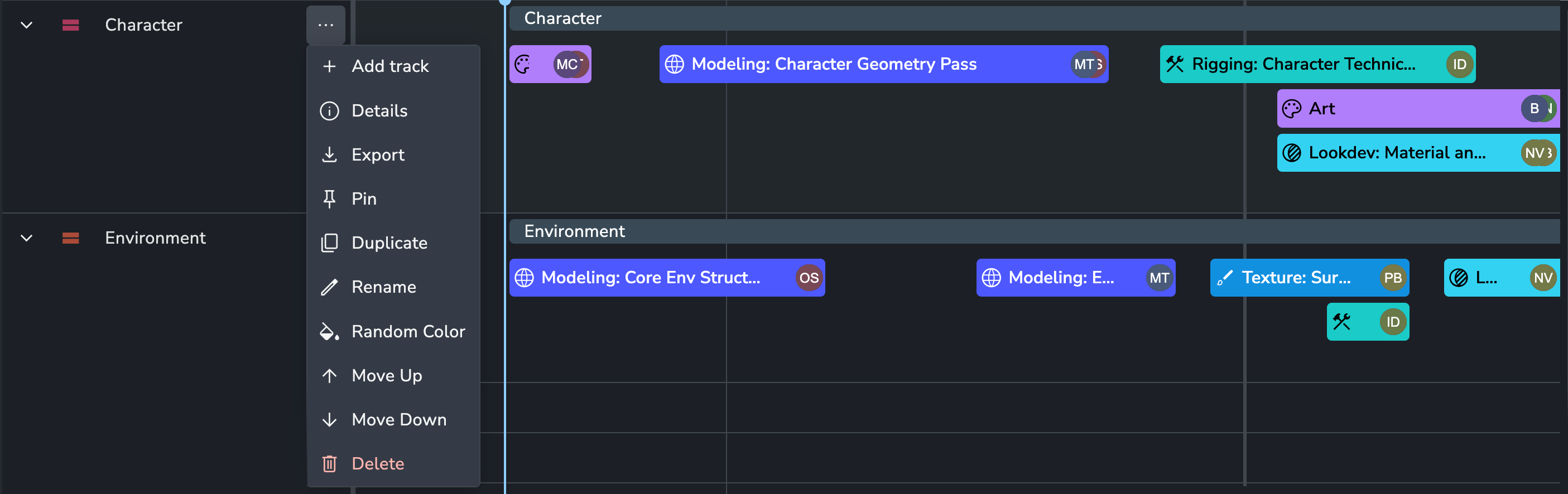

Management: You can Rename, Change Color, or Duplicate & Move tracks to standardize recurring structures.
Pinning: Important tracks (like artist bookings) can be Pinned to the top of the UI so they remain visible while scrolling through other data.
Random Color Shortcut: To quickly differentiate tracks, you can hold Ctrl/Cmd and click the track color icon to assign a "smart" random color.

Scheduler Interface

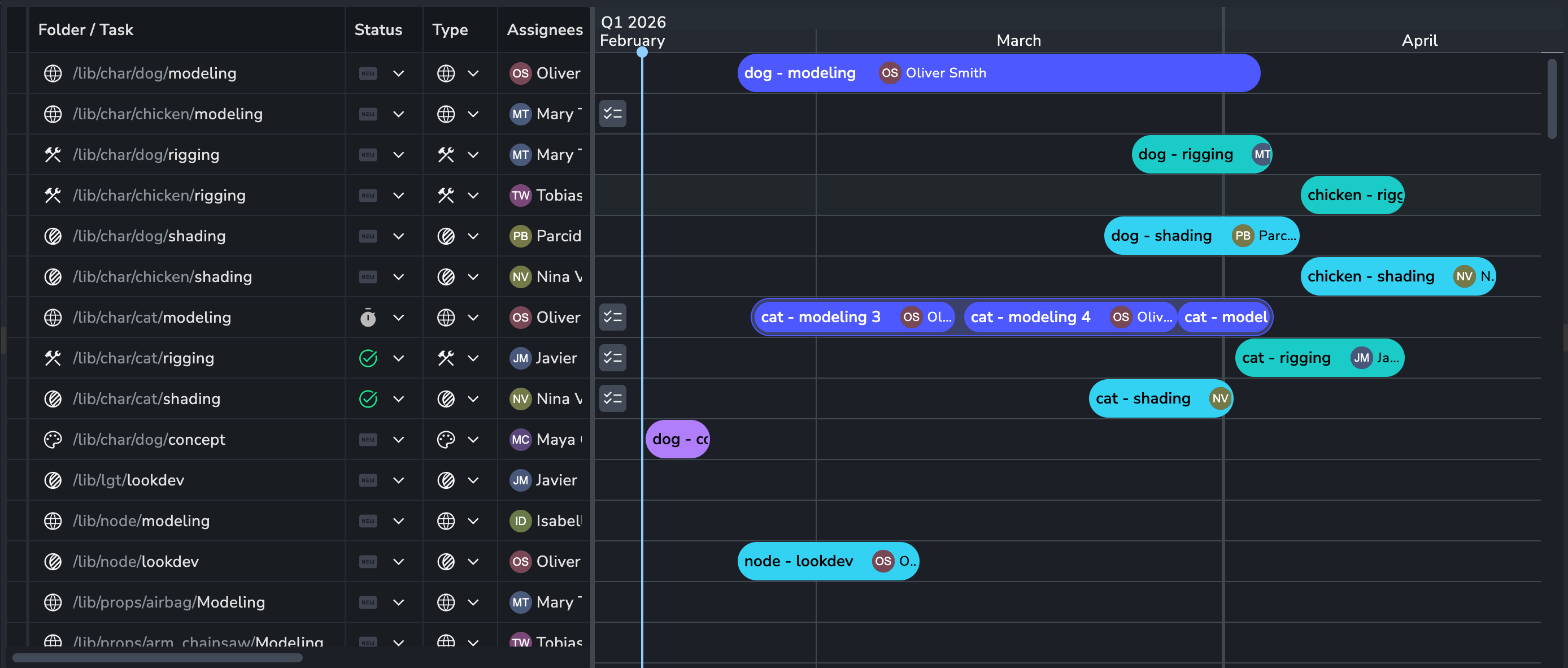

The Scheduler integrates the timeline with AYON's production data.
Slicer and Table: The left side features the standard Slicer and spreadsheet-like Table used in the Project Overview Page.
Hierarchy vs. Flat View: You can view tasks within their folder hierarchy or toggle Show Hierarchy off to see a flat list of all tasks.

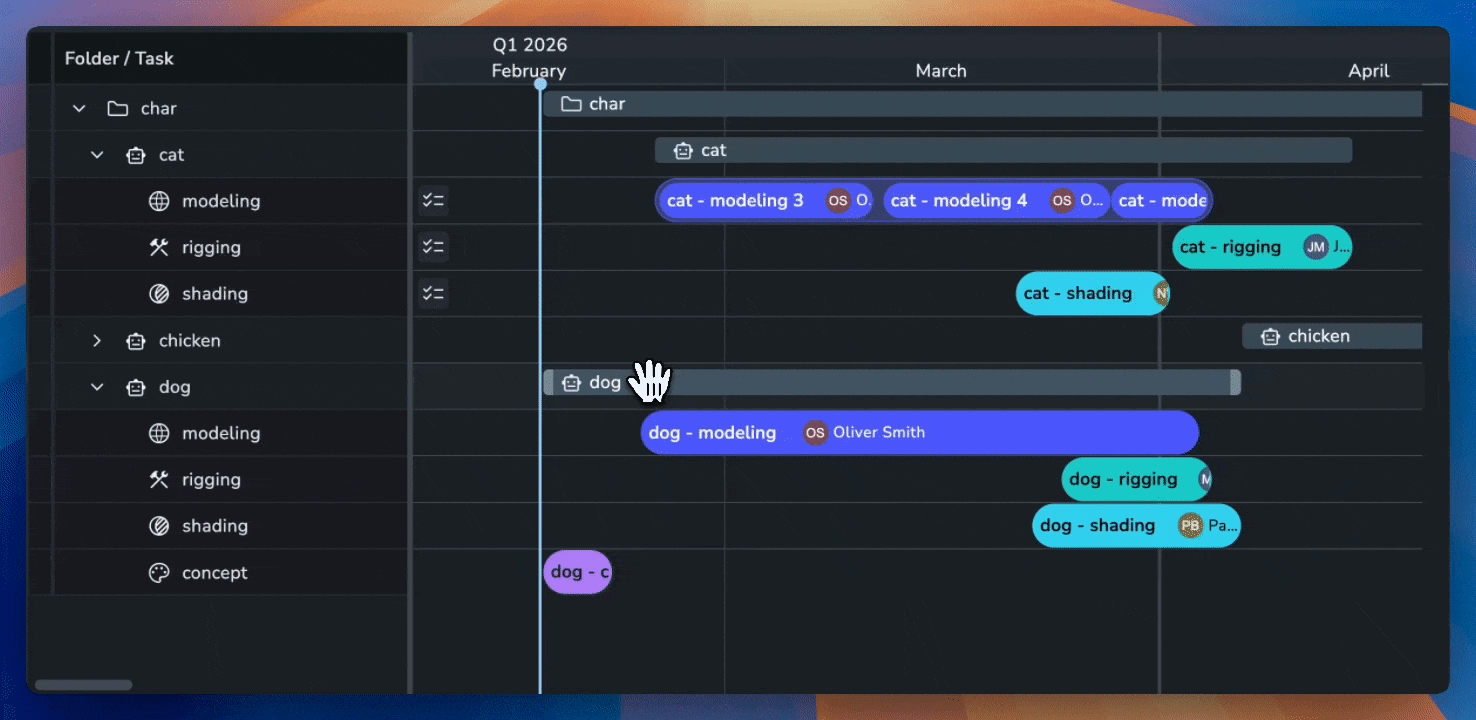

Folder Aggregation: While folders cannot be scheduled directly, the timeline displays an Aggregation Bar showing the total span of all tasks within that folder. Resizing this bar will proportionally resize all child task schedules.

Scheduler-Planner Overlay and Ghosting
This feature allows your high-level plan to inform your detailed scheduling.
Show Planner: Toggling this displays the current scenario's plan at the top of the Scheduler.

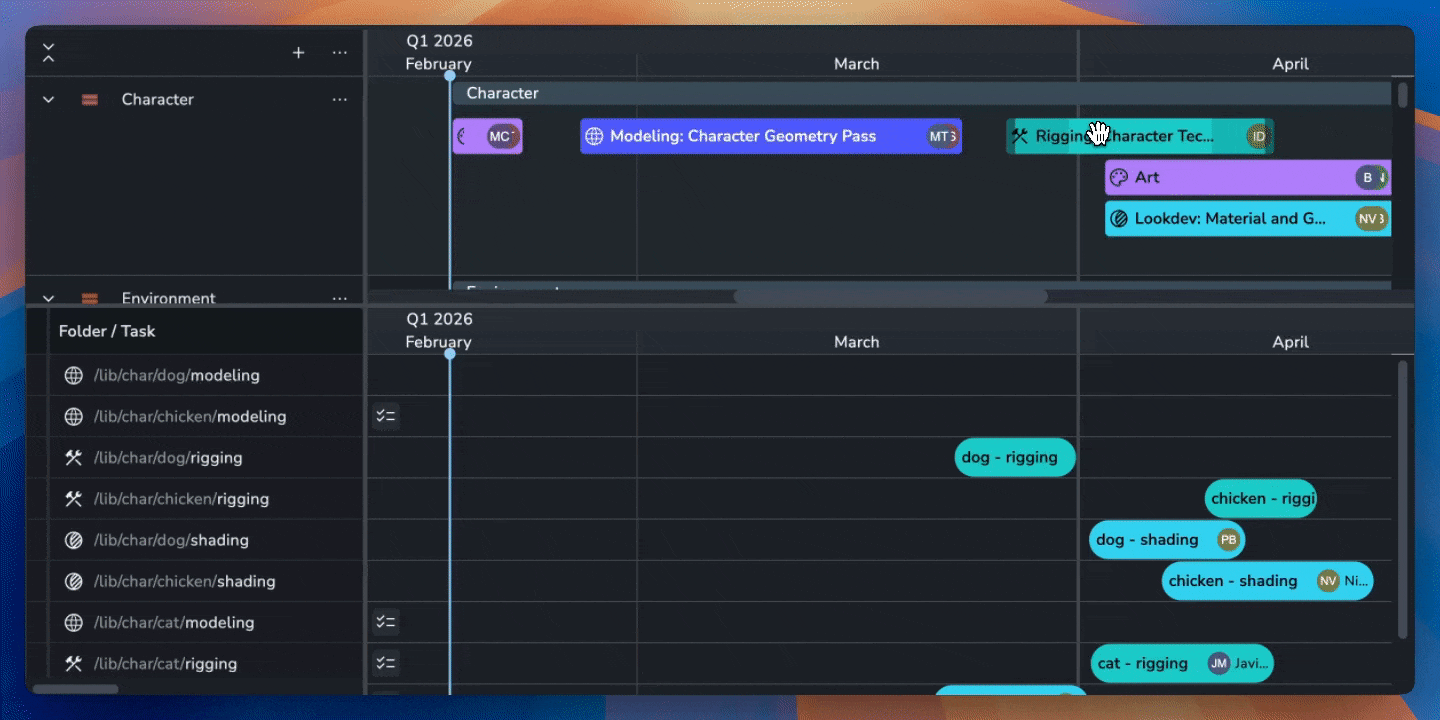

Ghosting: When a plan event is selected, it appears "ghosted" over the Scheduler tracks.
By Task Type: The plan only ghosts over tasks with a matching type (e.g., a "Modeling" plan ghosts over all modeling tasks).
By People: The plan ghosts over tasks where the assignees match the people in the plan event.
Ghosted can be disabled in the page customize settings.

Create Schedule Tool: Automatically creates task schedules based on a plan event. You can choose to apply the plan's dates to All tasks, specific Task Types, or specific People.

Scenarios
Scenarios act as independent "sheets" for testing different timelines without affecting production.
Live Scenario: You always have one Live scenario. Changes made here automatically update the

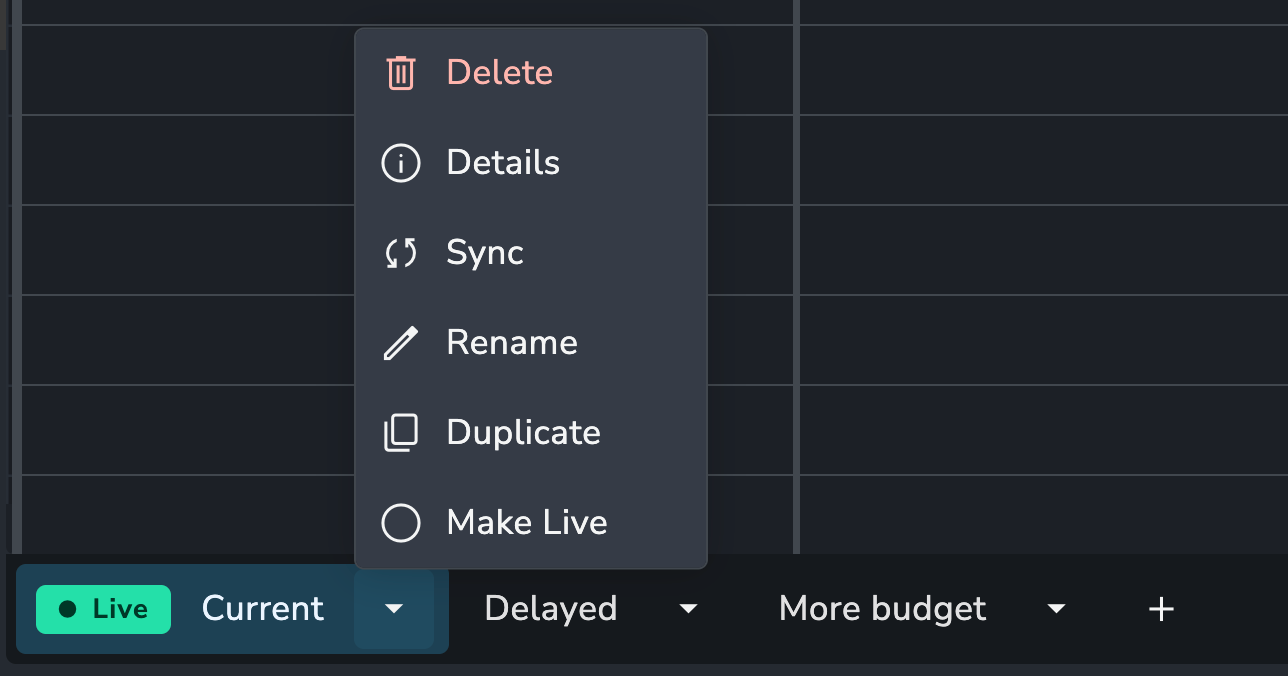

start dateandend dateattributes of the actual production tasks.Staging Scenarios: Non-live scenarios allow managers to explore "what-if" situations. When a plan is finalized, right-click the scenario and select Set as Live to push the dates to the artists' workboards.

Navigation and Controls
Off-screen Indicators: Small arrows on the left or right of the timeline signal that events exist outside the current view. Click the arrow or press G to jump to those events.
Interactive Zooming:

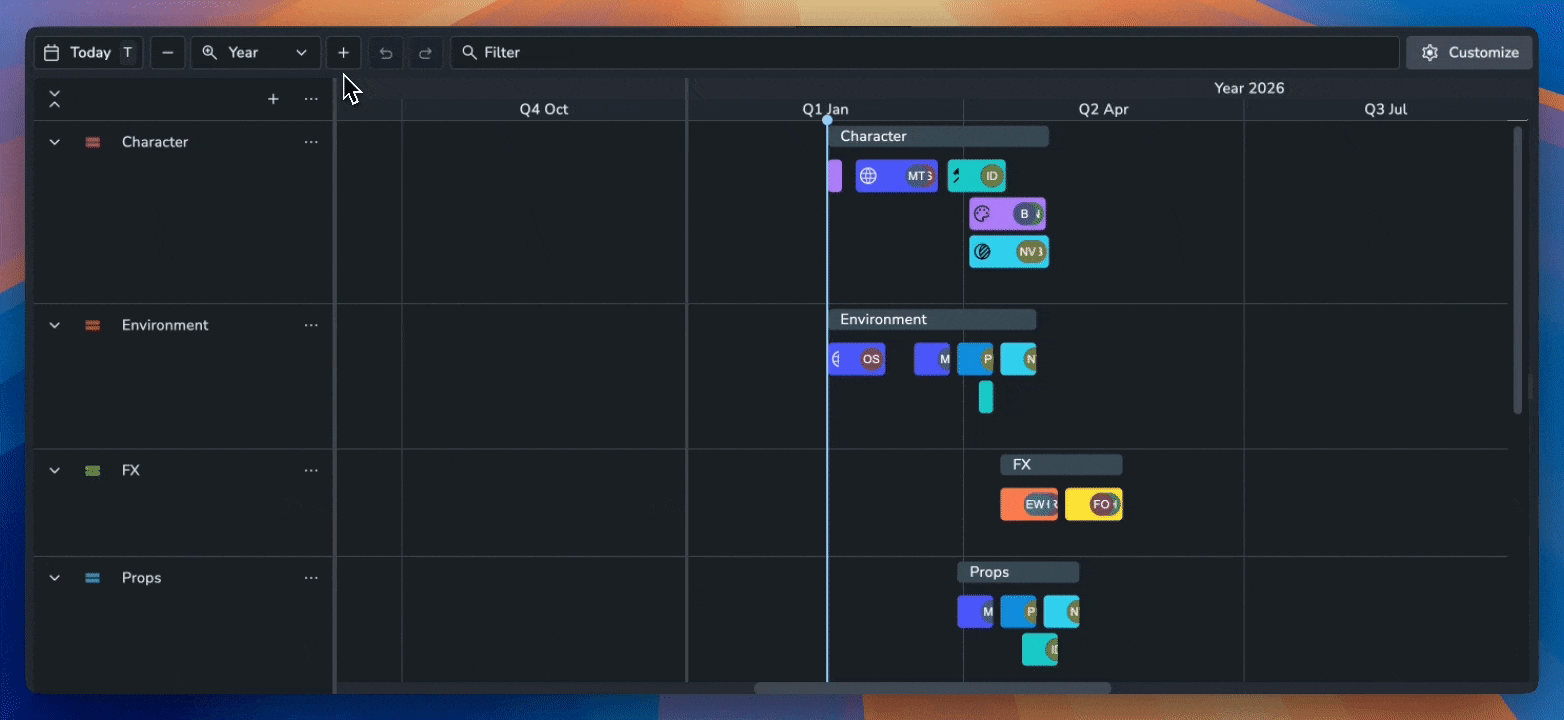

Dropdown menu for Day, Week, Month, Quarter, Year.
Click any interval header (e.g., a specific month) to zoom into it.
Hold Option/Alt and click a header to zoom out one level.

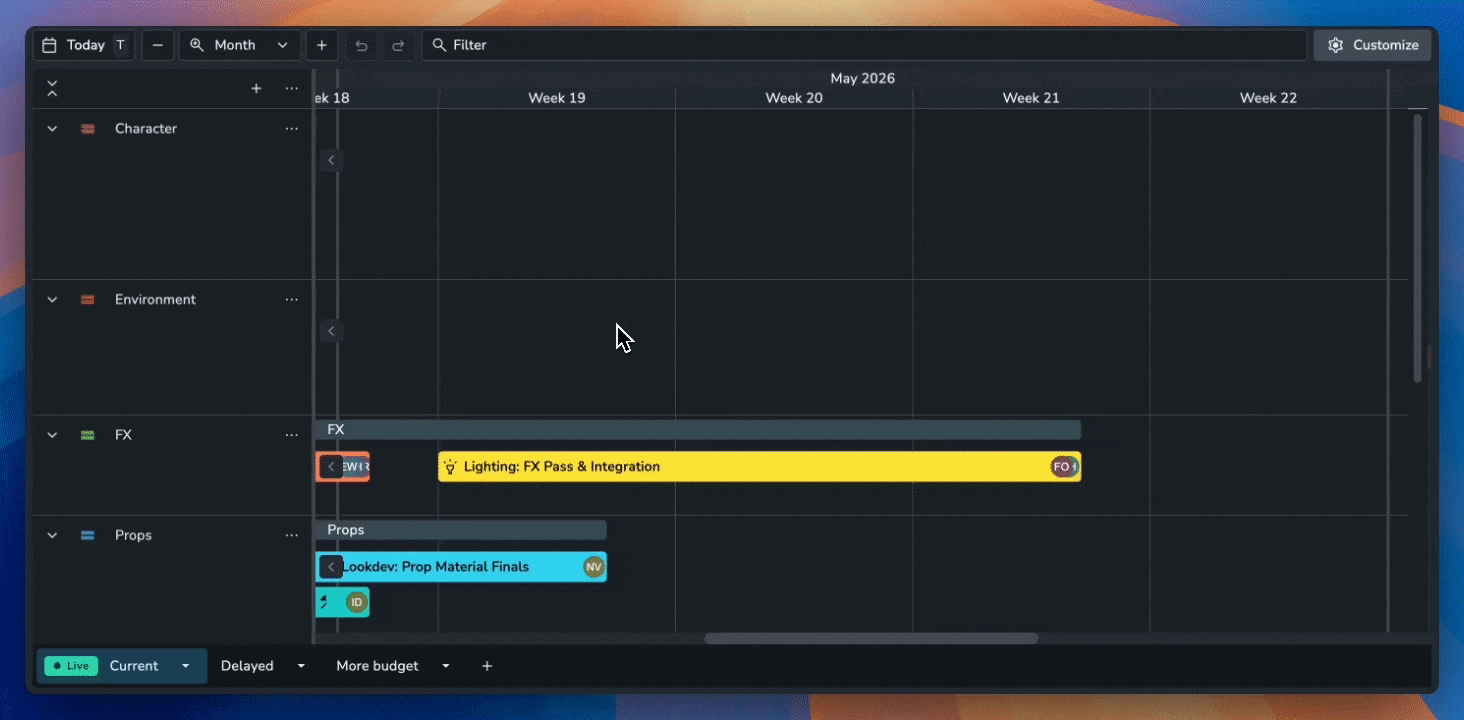

Fit to View: Hover over a track or event and press F to automatically adjust the zoom to fit that specific item.

Event Creation and Editing

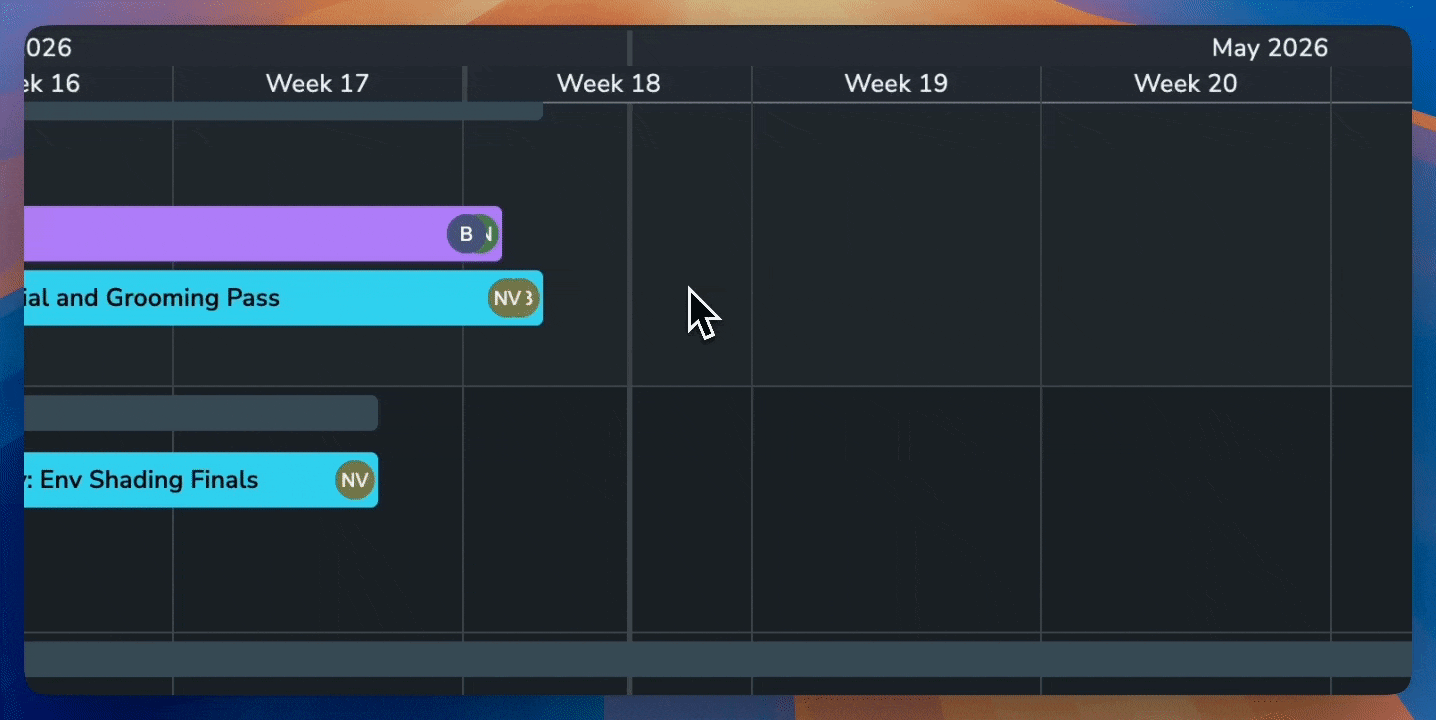

Creation: Hold Ctrl/Cmd and drag to create a new event, or press S to enter creation mode.

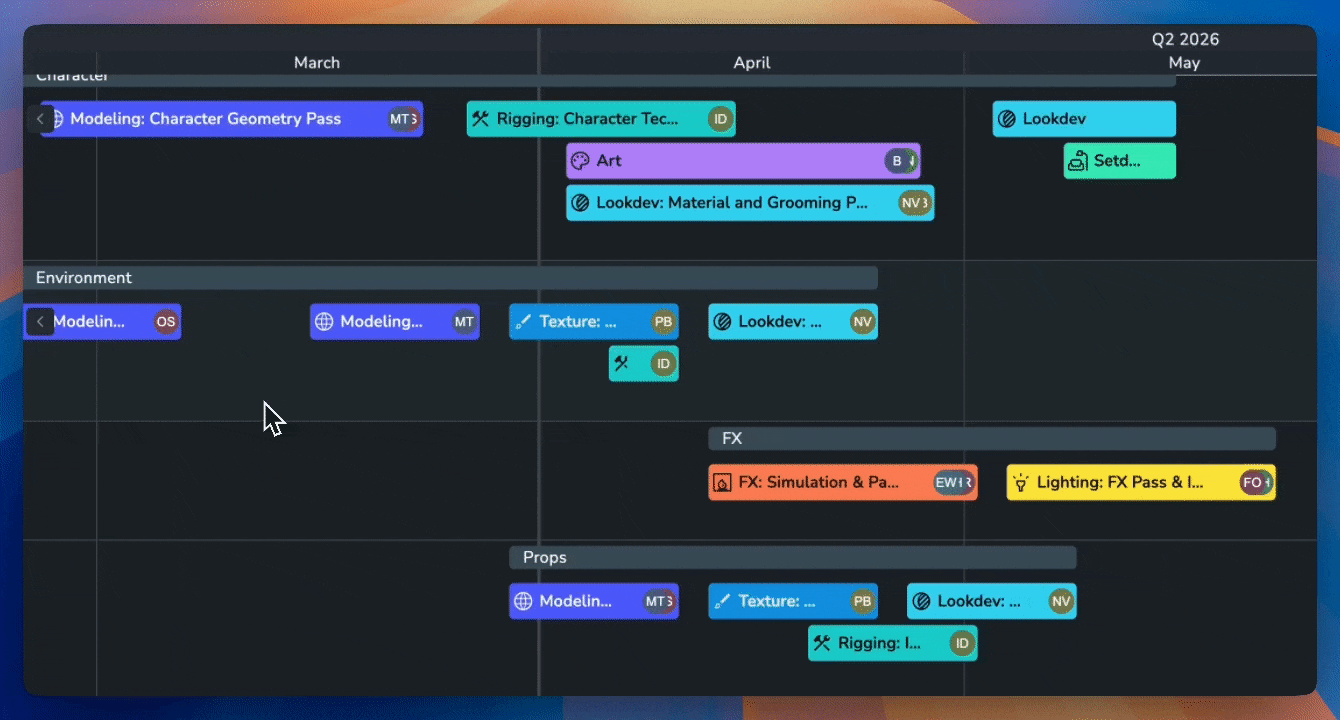

Selection: Left-click and drag now creates a Selection Box for selecting multiple events.
Multi-selection Move: Select multiple events and drag them together to shift a whole sequence of work.

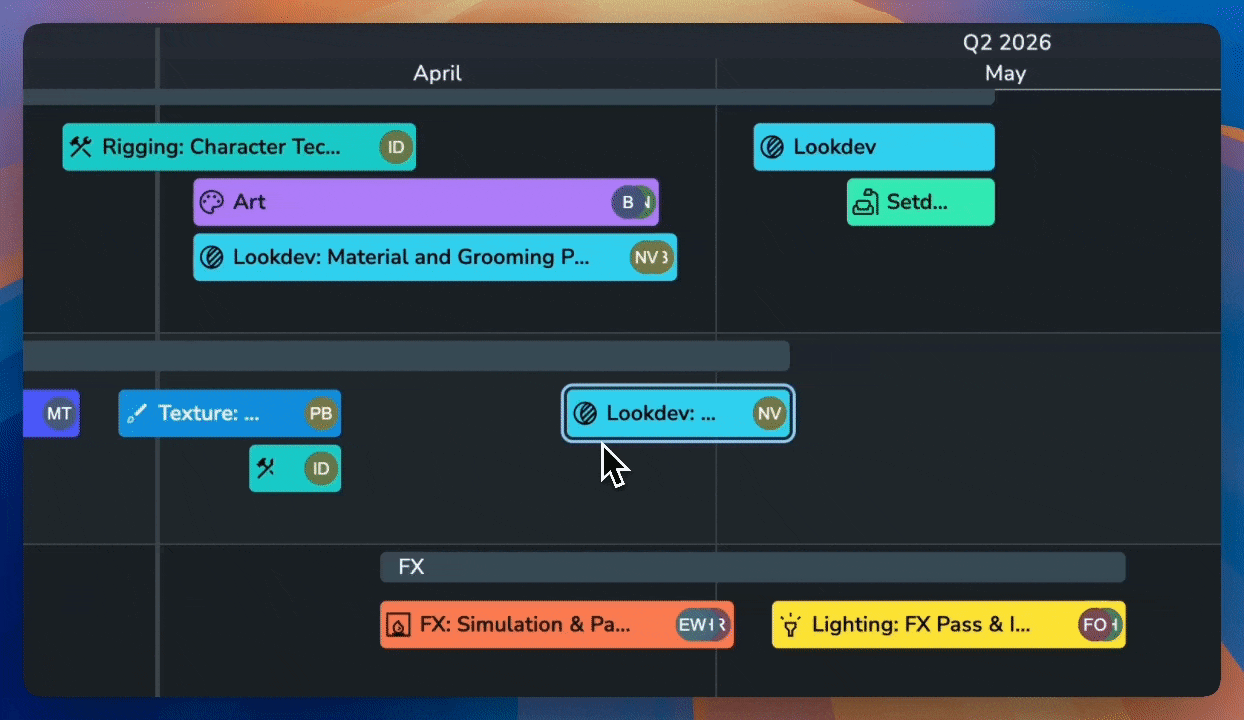

Snapping: When moving or resizing, a wider "faded handle" appears. Dragging near another event's edge will trigger a snap. This can be disabled in settings.

Copy, Paste, and Duplicate:
Standard Ctrl/Cmd + C/V shortcuts work.
Pasting uses the mouse position as the anchor point.

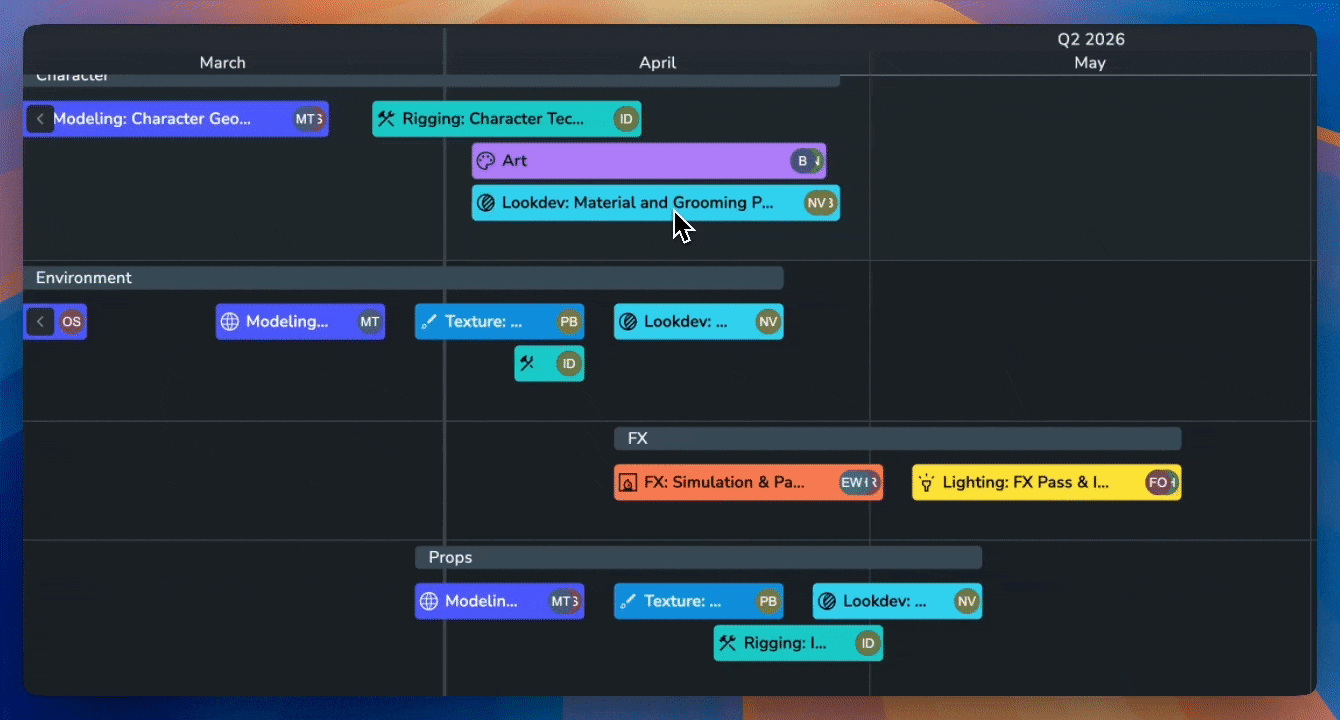

Duplication: Right-click to duplicate Down (same dates), Right (after), or Left (before).
Pro-Tip: Advanced Duplication Use the Shift + Option + Arrow Keys shortcut to "stamp" duplicates of an event.
Down: Creates a copy on a new row with the same dates.
Right: Creates a copy that starts exactly where the previous one ends (perfect for back-to-back tasks).

Spreadsheet Integration: Copied events use a standard spreadsheet format. This allows you to paste AYON events directly into Excel or Google Sheets for external reporting, or conversely, paste compatible data from a spreadsheet back into the timeline.
Undo & Redo
The planner and scheduler both support up to 50 local undo and redo actions. These work across changes to events, tracks and scenarios.
Use the buttons in the toolbar or the standard ctrl+z and shift+ctrl+z shortcuts.
Timeline Settings

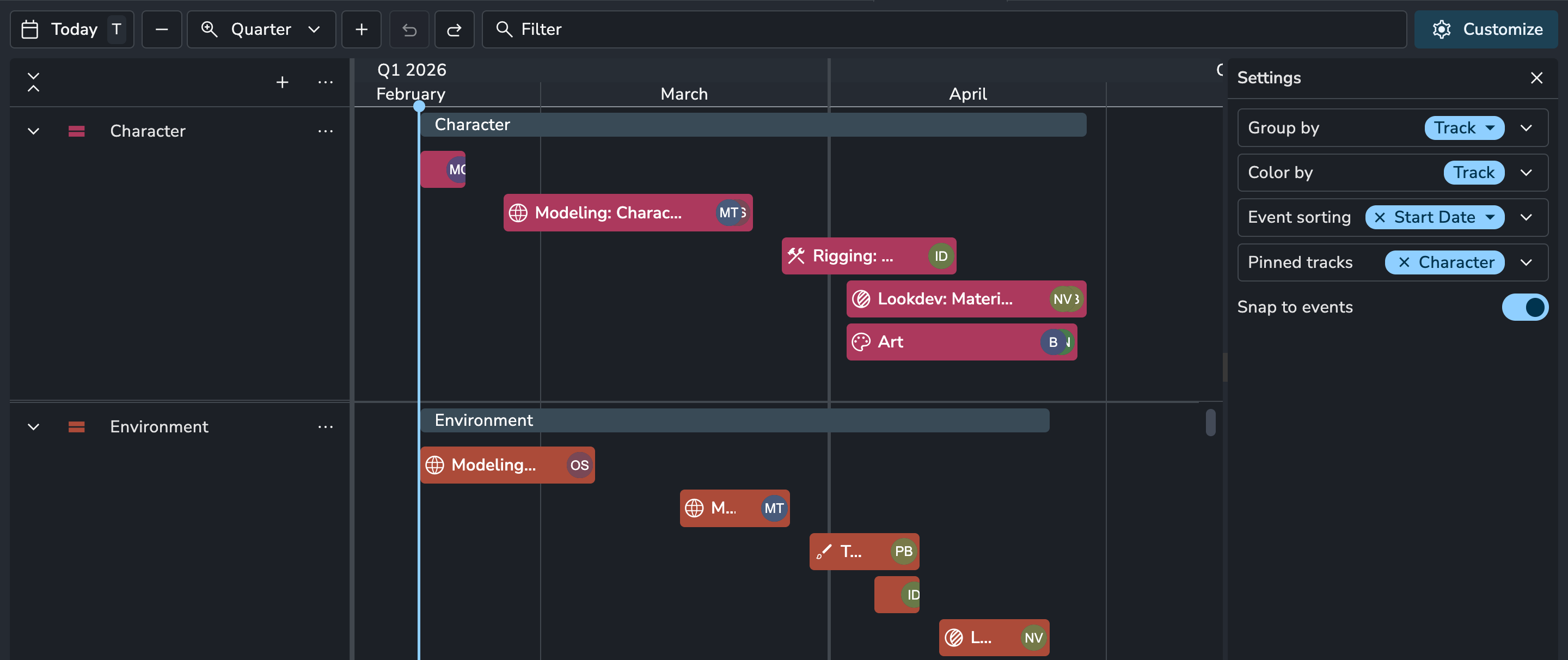

Color By: Quickly change event coloring via right-click. Options include Task Type, People, Status, and Priority.
Event Sorting:
Auto Sorting: Stacks events efficiently to save space.
One Row Per Event: Traditional Gantt style where every event has its own lane, sorted by Start Date, Duration, or Label.
Granularity: By default, events snap to days. Zoom in to a Day view to enable Hourly granularity for precise scheduling.

Views Support

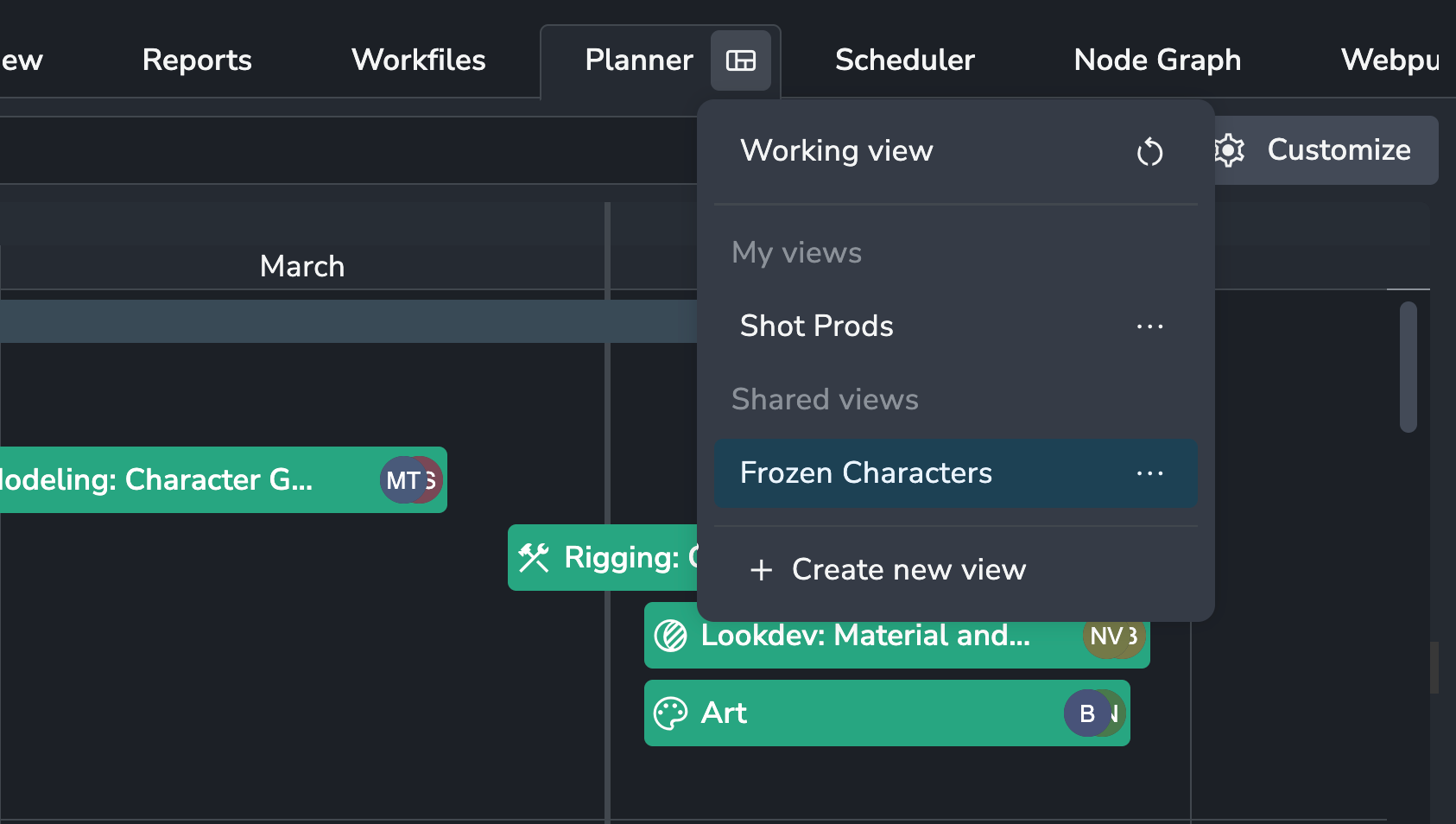

Both Planner and Scheduler fully support the Views system. You can save your specific filters, groupings, sorting, pinning, and zoom levels as a reusable View to share with the team.

Subtasks

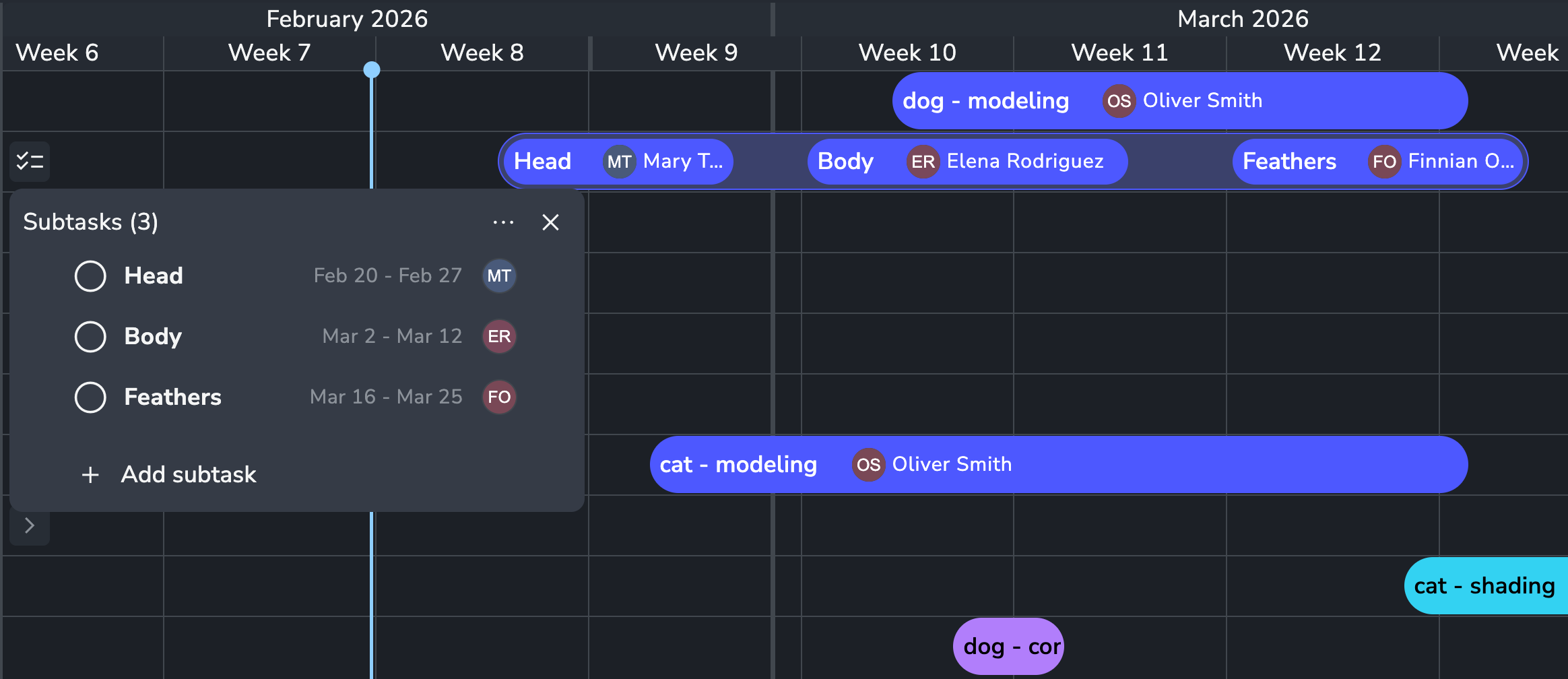

Management: Use the floating button on the left of a task to view and manage its subtasks.
Task Wrapping: By default, the parent task "wraps" around its subtasks, automatically expanding its duration to cover the earliest start and latest end dates of its children.
Splitting: Right-click a task schedule and select Split into Subtasks to divide a single block of work into smaller, manageable items at your mouse position.
Live Sync: Like tasks, subtask changes in the Live Scenario update the production task data instantly.

Export & Import

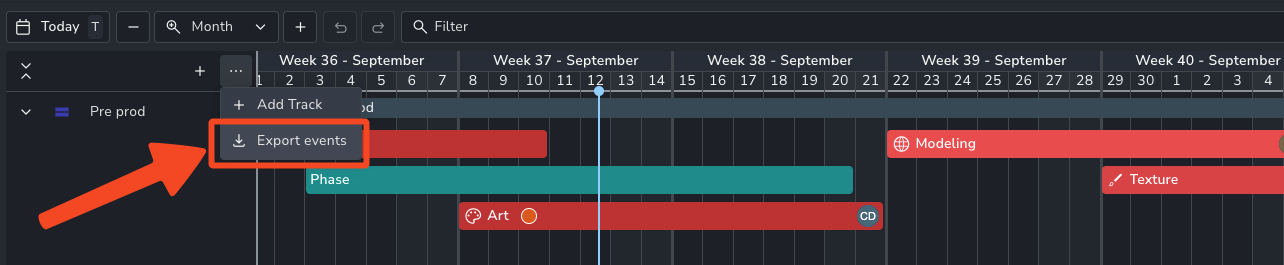

You can export events from the planner to be used in different softwares.

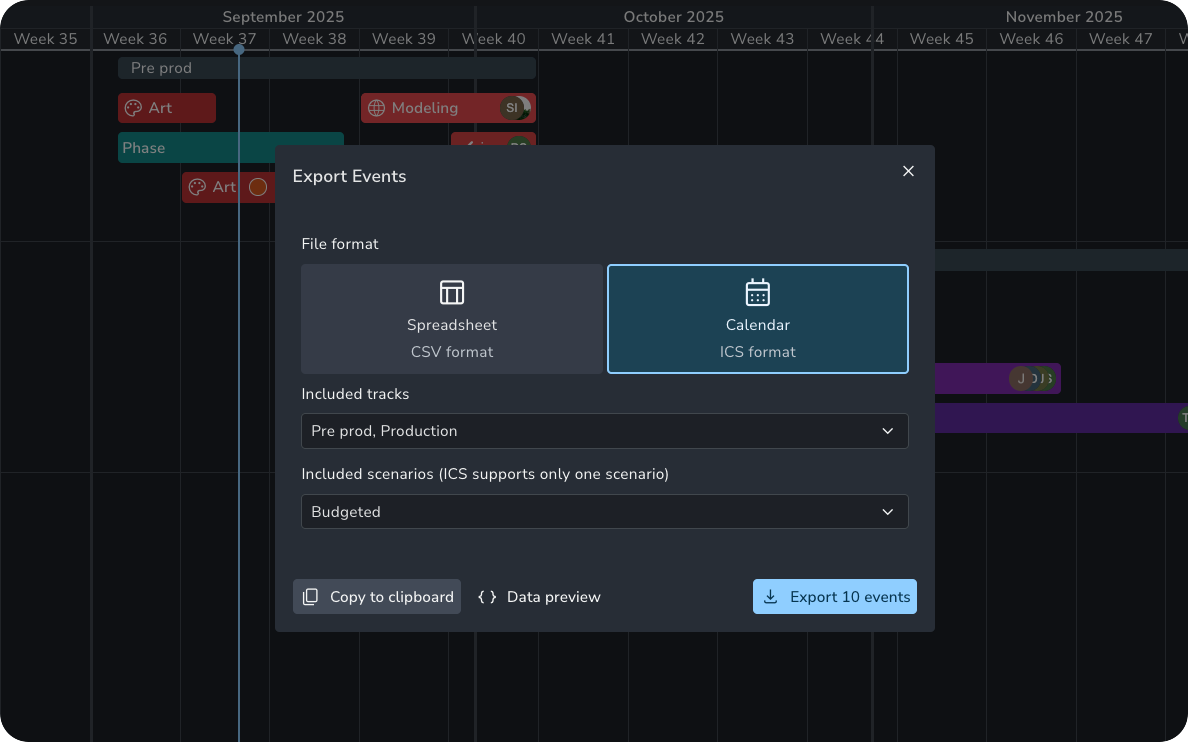

Export to CSV file (spreadsheet)
Export to ICS file (calendar)
Copy and paste to spreadsheets directly
Select specific tracks and scenarios to export


Data importing is planned for the roadmap, pending feedback from the data exporting update.
